HOME MenuBelleview Avenue, Jayro Court, and Riverview Street Improvement Project Project updates
Complete reconstruction of all pavements, sanitary sewer, watermain, storm sewer, services to each lot, and concrete curb and gutter and driveways.
Project updates
Thursday, November 19, 2026
Driveway aprons and outwalks are complete on phase 2. Bituminous base course is complete on phase 2. Upcoming work includes driveway patch work, black dirt restoration followed by sod.Tuesday, November 10, 2026
Curb and gutter is being placed 11-10 and 11-11 on phase 2, driveway aprons to follow. Mailboxes have been moved on Jayro Court. 30 day warranty period has expired on the sod on phase 1.
Upcoming work will include pouring of driveway aprons. Bituminous pavement on phase 2. Topsoil restoration and sod work on phase 2. Please do not drive on new curb or driveway aprons for 7 days after they are poured allowing enough time for the concrete to cure properly.
Tuesday, November 3, 2026
Subgrade preparation on a portion of Belleview Avenue, along with sub drain installation and class 5 gravel placement. The rain events have slowed this process down this week. The 10 day outlook is good for the rest of the week after 11-4 for upcoming operations.
Upcoming work will include sub grade preparation along with sub drain installation, on the rest of Belleview and Riverview. The plan will be to work Saturday 11-7 on the street work. Curb and gutter is also in the plans for early next week followed by bituminous pavement.
Thursday, October 29, 2026
All the sanitary and water services are complete in Phase 2. The temporary water system has been removed. Storm sewer has been installed in Phase 2 of the project.
Upcoming work will include subgrade preparation on Riverview and Belleview, along with subdrain installation. Gravel base section to be placed followed by curb and gutter for phase 2 of the project.
Thursday, October 22, 2026
Ongoing sewer and water service work on phase 2. Ongoing watering turf on phase 1. Upcoming work will include storm sewer install at north end of Riverview Street. Sub drain installation on phase 2 after sub grade excavation of phase 2.Wednesday, October 14, 2026
Sanitary sewer main and watermain have been installed in phase two of project. Watermain has been loaded and is under going testing. Service and storm sewer work will continue on 10-16 pending the watermain test results. Sod work has been completed on phase 1 and is being watered during the the 30 day warranty period. After the first week of November homeowners are to begin watering the sod placed in phase 1.
Upcoming work includes service connections, storm sewer connections and then road sub grade preparation with sub drain installation on phase 2.
Thursday, October 8, 2026
Sod has been placed on phase 1 on Belleview Avenue and Jayro Ct. Sanitary sewer has been installed in phase 2 on Belleview Ave. and is ongoing on Riverview Street.
Upcoming work will include watermain installation on phase 2. Followed by testing and private service hook ups, and storm sewer installation on phase 2.
Thursday, October 1, 2026
Trees have been installed on the east side of Jayro Court and the "No Parking" signs were moved back to the east side of Jayro Court to allow for the sod company to begin turf restoration. The contractor has remobilized 9-30 to begin cutting in temporary water service hook ups on phase two of the project.
Upcoming work will be sanitary sewer and water main installation on phase 2. Sod work on phase 1.
Wednesday, September 23, 2026
Trees on Jayro Ct. are being planted on 9-24 depending on the weather. The no parking signs have been moved to the east side of Jayro Ct. to leave room for the tree planters to perform that task. Once the trees are in they will be following up with the sod work on phase 1.
Upcoming work will be digging in temporary water hook ups in the street for each home on phase 2 followed by sanitary sewer mainline installation the week of 9-28.
Wednesday, September 16, 2026
Removals of existing curb, driveway aprons and road pavement on phase 2 of the project have occurred. Temporary water lines have been put together and loaded and are being tested. Black dirt has been installed on Phase 1.
Upcoming work includes sod and tree planting on phase 1 the week of 9-21. Phase 2 will resume with temporary water being connected to individual service lines in the street area. Sanitary sewer installation on phase 2 will begin the week of 9-21. Thank you residents for your continued cooperation on parking where the crews can have room to do the work.
Thursday, September 10, 2026
Blacktop has been placed on Belleview Avenue and Jayro Court. Topsoil has been placed in the same areas as the pavement. Structures were raised as well.
Upcoming work will be the start of Phase 2 Friday 9/11. Friday morning they will begin removals of curb, pavement, and driveway aprons at 7 am and plan on removing everything on phase 2 that same day. Temporary water system and cut ins on water services to follow the next week and sanitary sewer main line installation by end of the week beginning at the Jayro Court and Bellview Avenue intersection.
Please be aware of the no parking signs at the end of each working day as phase one will have ongoing work on turf restoration (sod) and tree planting. Thank You for your cooperation.
Wednesday, September 2, 2026
Driveway aprons have been poured in phase 1. Black dirt has been backfilled behind the curb on phase 1. Belleview Ave. and Jayro Ct. have been fine graded in preparation for the base course of bituminous pavement.
Upcoming work will base course of bituminous pavement placement on phase 1.
Thursday, August 27, 2026
Curb and gutter has been installed on Phase 1. Driveway forms are being set on Phase 1. Upcoming work for phase 1 is pouring driveway sections and fine grading the road section for a base course of bituminous pavement.Thursday, August 27, 2026
Storm drain work on phase 1 of the project is expected to be completed by the end of the day Friday, August 21st. Expect subgrade excavation/preparation and aggregate base placement in the phase 1 area of the road to follow.Wednesday, August 12, 2026
Sanitary sewer main and watermain have been installed from the Woodshire connection to the north end of Jayro Ct. Two days of water testing, then the contractor will continue by connecting sewer and water services. Upcoming work will be storm sewer connections and toe drain installation from Woodshire to the end of Jayro Ct.Wednesday, August 5, 2026
Sanitary sewer has been installed from Woodshire connection to the north end of Jayro Ct. Upcoming work is watermain installation in the same area.Thursday, July 30, 2026
Removals have taken place in phase 1. Temporary water lines have been laid out and loaded with water and are going through the texting process. Upcoming work is connecting temporary water lines to individual service lines once testing is complete. That is occurring week of 8-3.Wednesday, July 22, 2026

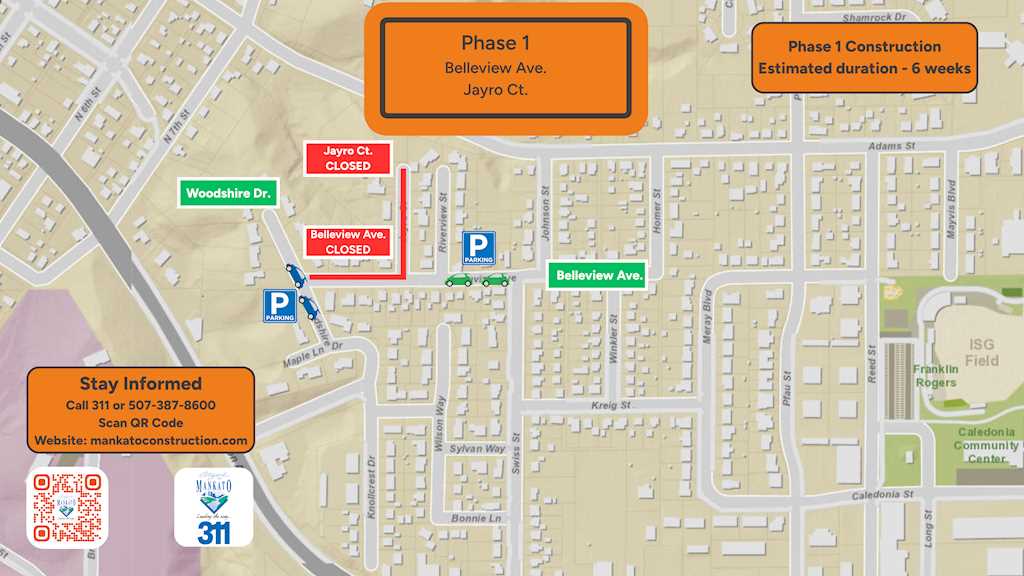

Phase 1 of the project is scheduled to start Monday, July 27th. The project limits of Phase 1 is Belleview Avenue between Woodshire Drive and Jayro Court and Jayro Court between Belleview Avenue and the dead end. Contractor mobilization, removals, temporary water hookups, and sanitary sewer construction is expected the first week of the project.
Thursday, July 16, 2026
Friday, July 10, 2026
Three utility poles have been installed on east side of Jayro Ct.Friday, July 10, 2026
Trees have been cleared on the east side of Jayro Ct.Friday, July 10, 2026
Utility work has not begun.
